Struggling with project delays and ruined budgets during ship refits? When interior panels clash with pipes and wires, costs skyrocket. Here is how you can stop these conflicts.
To prevent installation conflicts during marine refurbishments, you must enforce a strict 3-step strategy: mandate 3D clash detection before work begins, establish a rigid trade sequencing schedule (heavy piping, then HVAC, then electrical, then panels), and create dedicated material staging zones to stop workspace overlap.

Stopping these problems requires a clear plan. Let us look at the most common problem areas and how to fix them so your shipyard projects stay on track and under budget.
How Does Coordinating HVAC Ductwork Prevent Marine Ceiling Panel Retrofit Clashes?
Cramped ceiling spaces lead to crushed ducts and damaged panels. If your teams work blindly, you will pay for rework. Proper coordination solves this tight space problem.

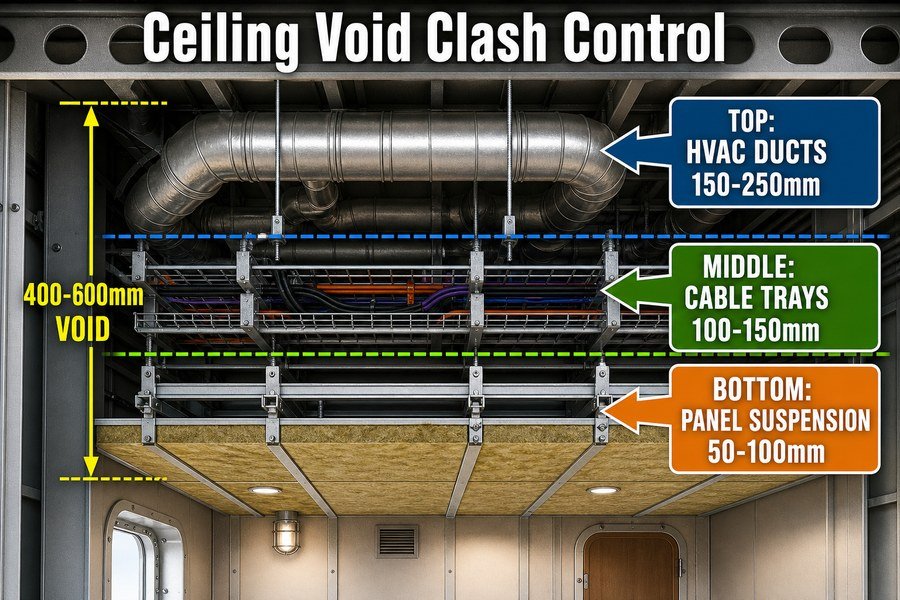

Coordinating HVAC ductwork prevents ceiling clashes by defining the 3 critical zones within the 400mm to 600mm ceiling void: the top zone for large HVAC ducts, the middle zone for cable trays, and the bottom zone for the ceiling panel suspension systems, ensuring no physical overlap.

Defining the Top Zone for Large HVAC Ductwork in Marine Ceilings
Shipyards in Europe and the US demand precision. According to ISO 7547 standards for air-conditioning and ventilation of accommodation spaces, HVAC ducts can be large. They often require 150mm to 250mm of vertical space. If we do not put them at the very top of the ceiling void, they will block everything else. In my days at the factory, I saw many projects fail because workers just put ducts wherever they wanted. The total void space in a standard cabin is usually only 400mm to 600mm deep. If we reserve the top 200mm exclusively for HVAC, we save the rest of the space for the other trades. This top-down approach is basic but it is the most effective rule you can follow.
Managing the Middle Cable Tray Zone and Bottom Panel Suspension Zone
Next, we must manage the middle and bottom zones. The middle zone is strictly for electrical cable trays. These trays need about 100mm to 150mm of height. We place them right below the HVAC ducts. The cables can easily branch off to the sides. Finally, the bottom zone is for the ceiling panel suspension system itself. The marine ceiling panels, like B-15 fire-rated ceilings1, need about 50mm to 100mm of clearance for the hanging profiles and steel clips. If we follow this strict 3-zone rule, the panels will fit perfectly every time. I always tell my clients to enforce this rule early in the project. If you do not tell your teams where to put things, they will guess, and guessing causes clashes.
| Ceiling Void Area | Component Type | Standard Clearance Requirement | Priority Level for Installation |
|---|---|---|---|
| Top Zone | Main HVAC Ventilation Ducts | 150mm to 250mm | 1 (First to install) |
| Middle Zone | Electrical Cable Trays | 100mm to 150mm | 2 (Second to install) |
| Bottom Zone | Marine Ceiling Suspension Profiles | 50mm to 100mm | 3 (Last to install) |
Why Does Concurrent Electrical Work Obstruct Marine Wall Panel Replacement?
When electricians and panel installers work in the same cabin, chaos happens. Wires get trapped and schedules get delayed. You must separate their work to succeed.

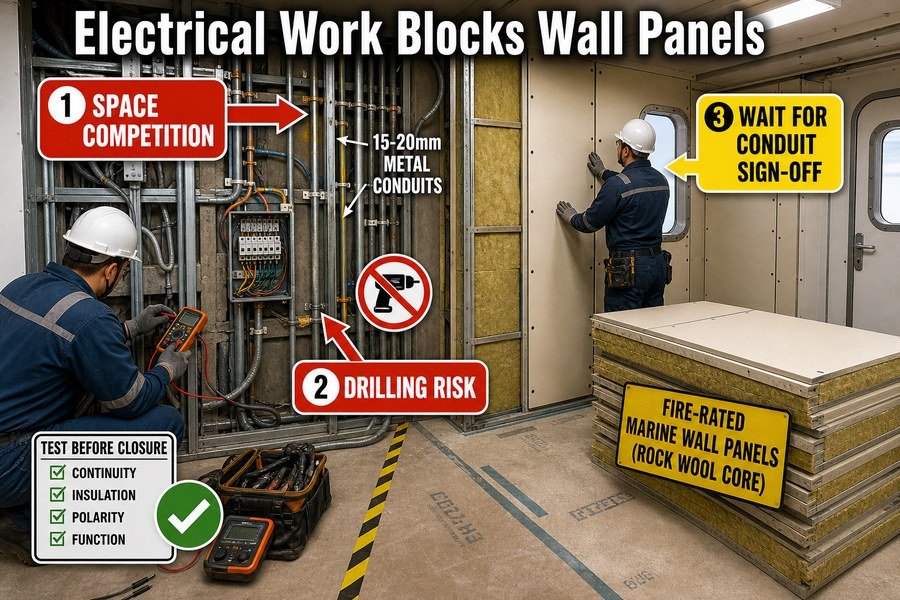

Concurrent electrical work obstructs wall panel replacement through 3 main issues: physical space competition in tiny cabins, the risk of drilling into active wires, and the inability to close panel joints until all 15mm to 20mm cable conduits are fully tested and signed off by inspectors.

Addressing Physical Space Competition and Wire Drilling Risks in Tiny Cabins
Let me share what happens when two trades fight for space. A standard crew cabin is often just 8 to 12 square meters. This is a very tiny physical space. If electricians pull wires while my team installs B-15 marine wall panels, they bump into each other. This physical space competition slows down both teams by at least 30%2, according to shipyard time-motion studies. Even worse is the safety risk. Marine wall panels require self-tapping screws for the base profiles. If electricians hide temporary active wires behind the profiles, my workers might drill into them. This creates a severe fire risk3 and can ruin the entire electrical system of that block. You cannot let these teams work at the exact same time.
Managing Conduit Testing Delays Before Closing Marine Wall Panel Joints
The third major obstruction is the sign-off process. We cannot snap the marine wall panels together and close the joints until the electrical work is finished. Ships use 15mm to 20mm metal conduits for cables. Under SOLAS regulations, an inspector must test and approve these electrical conduits before we hide them behind fire-rated wall panels.4 If electricians are still working, we have to leave the panels open. This blocks our progress. When you buy panels from Asia, you want to install them fast to save labor costs in Europe. You cannot do that if you are waiting for electricians. The solution is simple: electricians must finish and get their signatures before the wall panels arrive in the room.
| Obstruction Type | Cause of Conflict | Impact on Schedule | Mandatory Solution |
|---|---|---|---|
| Physical Space | Too many workers in an 8-12 sqm cabin | 30% reduction in work speed | Schedule trades on different days |
| Safety Risk | Blind drilling into active wires | Major rework and fire hazard | Install base profiles before wiring |
| Testing Delays | Waiting for SOLAS conduit inspection | Stops panel joint closure | Complete electrical sign-off first |
How Do Shared Corridors Restrict Marine Wall And Ceiling Panel Installation?
Narrow ship corridors turn into traffic jams during refurbishments. This logistics nightmare eats your profit margins fast. Clear path rules keep your panels moving.

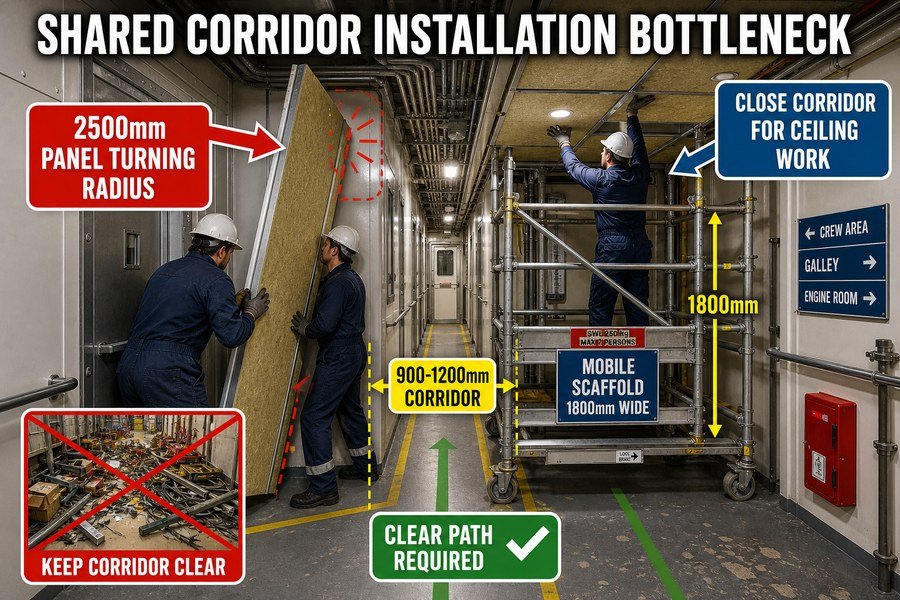

Shared corridors restrict installation in 2 ways: the 900mm to 1200mm corridor width physically blocks the turning radius for standard 2500mm wall panels, and heavy foot traffic from other trades stops installers from setting up mobile scaffolding needed for ceiling panel suspension work.

Navigating the Narrow Turning Radius for Standard Marine Wall Panels
Ship corridors are not like hotel hallways. Based on the International Convention on Load Lines and typical vessel designs, marine corridors are very narrow. A standard cabin corridor is usually between 900mm and 1200mm wide.5 Meanwhile, standard marine wall panels are often 2000mm to 2500mm long and 550mm wide. When workers try to carry these large wall panels through a 900mm corridor and turn into a cabin door, the physical turning radius is completely blocked. If plumbers leave pipes in the hall, it is impossible to move the panels without scratching them. I have seen beautiful, high-quality panels get deep scratches because the corridor was full of trash. We must clear the halls before moving panels.
Managing Heavy Foot Traffic and Mobile Scaffolding for Marine Ceiling Panels
The second restriction is about the ceiling work. To install B-0 or B-15 marine ceiling panels in a corridor, workers must use mobile scaffolding. These scaffolds are about 1800mm high. However, if the corridor is shared, heavy foot traffic from electricians, pipefitters, and welders will constantly interrupt the ceiling team6. Every time someone needs to pass, my guys have to climb down and move the scaffold. This wastes hours every day. If labor costs $50 per hour in the US, moving scaffolds wastes hundreds of dollars per shift. You must close the corridor to other trades while the ceiling team is working. This is the only way to protect your labor budget.
| Obstacle Type | Standard Dimension | Panel/Equipment Dimension | Required Management Action |
|---|---|---|---|
| Narrow Width | 900mm to 1200mm corridor | 2500mm long wall panels | Clear all floor debris before moving |
| Heavy Traffic | 10+ workers per hour | 1800mm high mobile scaffold | Close corridor to other trades during work |
What Sequencing Prevents Rework Between Marine Ceiling Panels And HVAC Or Electrical Retrofits?
Doing work in the wrong order guarantees you will tear it down. Rework kills your timeline and destroys materials. The correct sequence is your only defense.

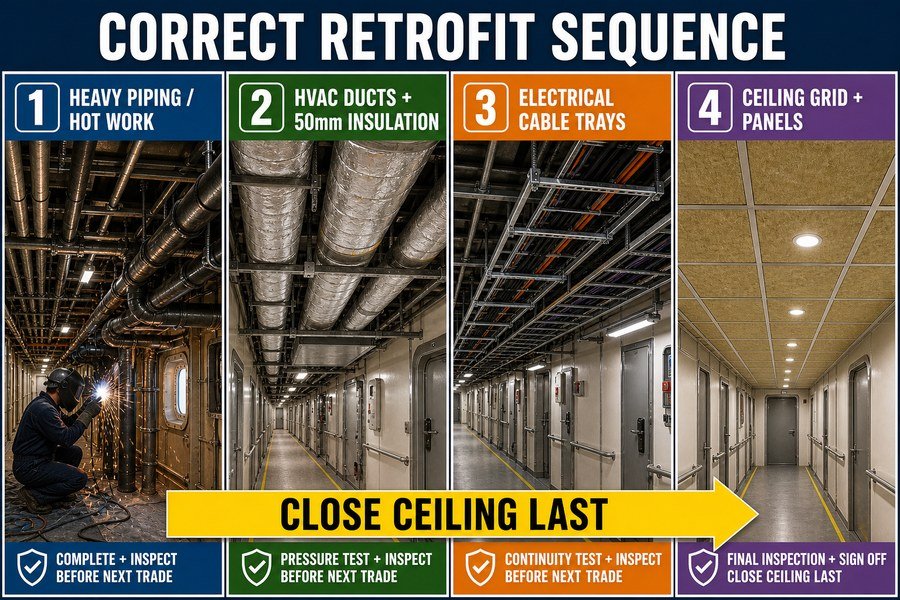

The proven 4-step sequence to prevent rework is: first install heavy hot-work pipes, second install and insulate the HVAC ductwork, third pull and secure the electrical cable trays, and fourth install the ceiling panel grid and tiles as the final closure layer.

Executing Heavy Piping and HVAC Ductwork Installation First
At Magellan Marine, I always tell procurement officers that buying good materials is only half the job. The installation sequence is just as important. The 4-step sequence starts with heavy hot-work pipes. Welders must finish all steel pipe repairs and fire-line installations first. Welding creates sparks and slag.7 If you install marine ceiling panels first, the sparks will burn the painted surface of the panels. Second, the mechanical team must install the HVAC ductwork. These ducts require thermal insulation to prevent condensation.8 Workers need space to wrap the 50mm thick rock wool around the ducts.9 They cannot do this if the ceiling grid is already hanging in their way.
Completing Electrical Cable Trays Before Final Marine Ceiling Panel Closure
Third, after the large ducts are in place, the electrical team must pull their cables and secure the cable trays. Electrical cables are flexible, so they can bend around the rigid HVAC ducts. The electricians must test the circuits to ensure safety. Only after the first three steps are 100% complete and inspected can we move to the fourth step.10 The fourth step is installing the marine ceiling panel suspension grid and the ceiling tiles. The ceiling is the final closure layer. It hides all the messy pipes and wires above it. If you follow this 4-step sequence, you will never have to remove a clean ceiling panel to fix a leaky pipe. This protects your material investment.
| Sequence Step | Trade Discipline | Key Activities | Why It Must Be Done in This Order |
|---|---|---|---|
| Step 1 | Pipefitters / Welders | Install heavy pipes, hot work | Prevents welding sparks from burning panels |
| Step 2 | HVAC Mechanics | Hang and insulate large ducts | Requires maximum open space for 50mm insulation |
| Step 3 | Electricians | Pull cables and mount trays | Cables can route around fixed HVAC ducts |
| Step 4 | Outfitting Team | Install ceiling grid and panels | Acts as the final visual closure layer |
How Does Limited Onboard Storage Space Complicate Marine Wall Panel Staging?
Ships have zero extra room for material storage. If your panels sit in the open, they get ruined. Smart staging prevents massive material loss.

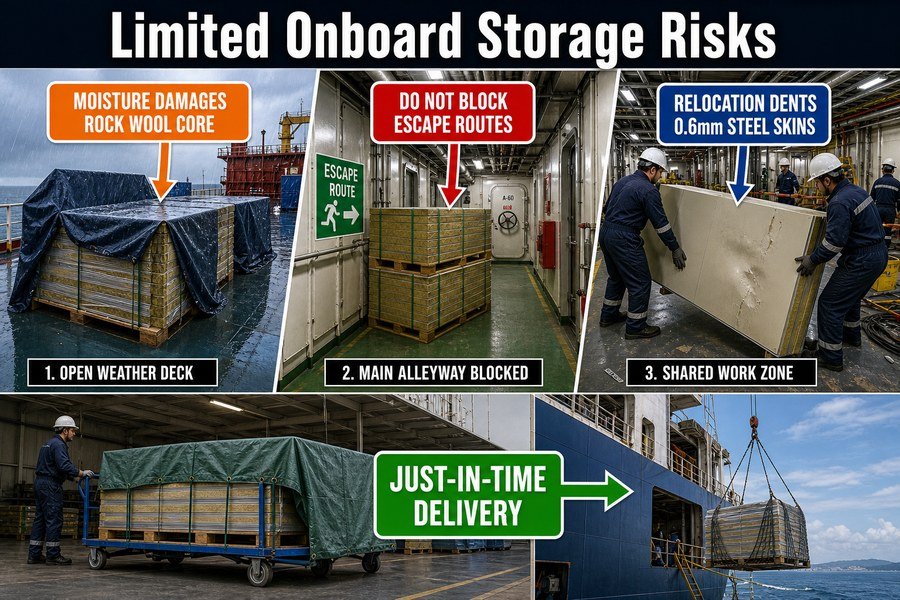

Limited onboard storage complicates panel staging by forcing 3 bad outcomes: panels stacked in open weather decks suffer moisture damage to their mineral wool cores, scattered panels block escape routes violating safety codes, and constant relocation of panels causes dents in the 0.6mm galvanized steel skins.

Preventing Moisture Damage to Mineral Wool Cores on Weather Decks
Staging materials on a ship is incredibly difficult because every square inch is used for machinery or cabins. When a shipyard buys containers of A-60 or B-15 marine wall panels, they must store them somewhere. The first bad outcome of limited space is that managers often leave the pallets on the open weather decks. Marine wall panels use rock wool cores for fire protection. While the steel skin is strong, the edges are sometimes open. If it rains, the mineral wool core absorbs moisture like a sponge. Wet rock wool loses its SOLAS fire rating11 and becomes useless. You cannot dry it out. You must throw it away and buy more, which destroys your budget.
Avoiding Blocked Escape Routes and Dents in Galvanized Steel Skins
The second and third bad outcomes happen when people try to cram panels inside the ship. Workers often leave stacks of panels in the main alleyways. This blocks the emergency escape routes12, which is a direct violation of IMO safety codes. Port state control inspectors will stop your project if they see this. Because the panels block the way, other trades constantly move them around to get past. Marine wall panels usually have a 0.6mm or 0.7mm PVC-coated galvanized steel skin. This skin is durable, but if workers drag or drop the panels multiple times, the steel gets deep dents and scratches. To fix this, you must use a "just-in-time" delivery method from the warehouse to the ship.
| Storage Location | Primary Risk Factor | Material Damage Result | Prevention Strategy |
|---|---|---|---|
| Open Weather Deck | Rain and sea spray | Wet mineral wool loses SOLAS rating | Store in covered warehouse off-ship |
| Main Alleyways | Blocks IMO safety escape paths | Project stopped by inspectors | Stage only daily required amounts |
| Shared Work Zones | Constant relocation by other trades | Dents in 0.6mm galvanized steel skin | Use "just-in-time" delivery schedule |
How Do Cabin Handover Deadlines Dictate Marine Wall And Ceiling Panel Retrofit Schedules?
Missing a cabin handover deadline means the ship cannot sail. The penalties for late ships are huge. Your schedule must align with the final date.

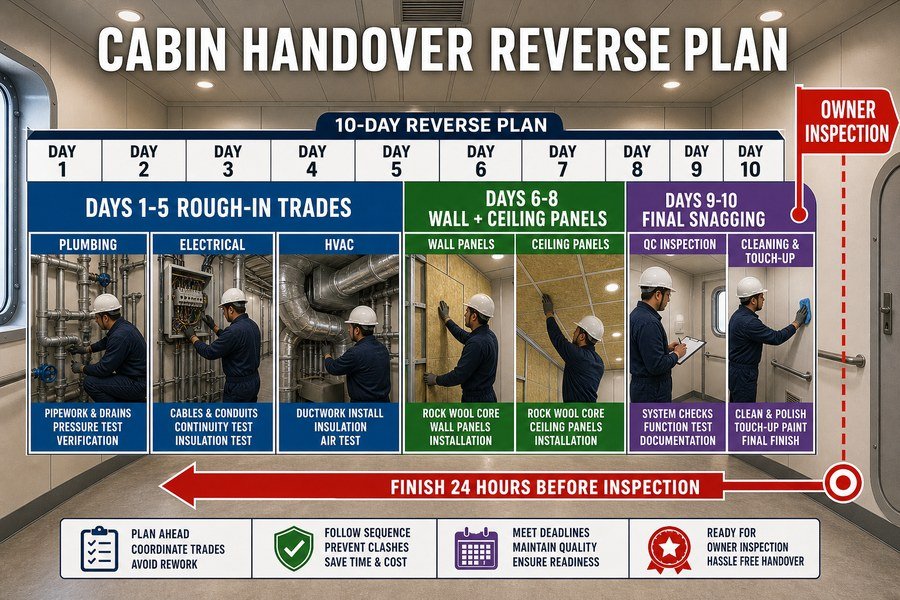

Cabin handover deadlines dictate retrofit schedules by requiring a strict reverse-planning timeline: assigning 5 days for rough-in trades, 3 days for wall and ceiling panel installation, and 2 days for final snagging, ensuring the interior decorator finishes exactly 24 hours before the ship owner's final inspection.

Allocating 5 Days for Rough-In Trades and 3 Days for Panel Installation
In the cruise and commercial shipping world, time is literal money. A shipyard contract often includes late penalties of $10,000 to $50,000 per day13. Because of this, cabin handover deadlines absolutely dictate how we schedule the marine wall and ceiling panels. We use a reverse-planning timeline. Let us say we have a 10-day window to refit a cabin. We start from the deadline and work backward. We must give the first 5 days to the rough-in trades14. This includes plumbers doing pipework, electricians pulling main lines, and HVAC teams hanging ducts. If they do not finish in 5 days, my panel schedule is ruined.
Next, we allocate exactly 3 days for the marine wall and ceiling panel installation. My team comes in and sets the floor tracks, erects the B-15 wall panels15, installs the marine fire doors, and hangs the B-0 ceiling tiles16. This is hard work, but we can do it if the rough-in trades are gone.
Reserving 2 Days for Final Snagging Before the Owner's Inspection
This timeline leaves exactly 2 days for final snagging. Snagging means checking for small defects, wiping down the PVC film on the panels, and touching up paint on the door frames. We must finish all of this exactly 24 hours before the ship owner arrives for the final inspection. If you manage procurement, you must ensure your Asian suppliers deliver the materials weeks before this 10-day window starts. Logistics delays will destroy this tight schedule. You must have all parts on hand before day one begins.
| Day Number | Responsible Team | Task Description | Deadline Criticality |
|---|---|---|---|
| Days 1-5 | Plumbers, Electricians, HVAC | Install pipes, wires, and ducts | Must finish so panel work can start |
| Days 6-8 | Outfitting Installers | Erect wall panels, doors, ceilings | Defines the room shape and fire zones |
| Days 9-10 | Quality Control Team | Clean panels, fix small defects | Must pass owner inspection on Day 10 |
Conclusion
By coordinating HVAC, sequencing electrical trades, managing corridor logistics, and planning storage carefully, you can stop installation clashes. This keeps your marine outfitting projects profitable and on time.
-
